Daily Field Report
Observations/Finding
At the request of the client’s representative, our AS ENGINEERING AND CONSULTING, LLC (ASEC) representative, Amin Azimi visited the job site to observe the contractor’s work activities from a quality standpoint to verify compliance with project drawings/specifications, applicable codes, and materials submittals and conducted QC testing per the project drawings and specifications. The following observations were made during our evaluation:
This report provides an assessment of the footing excavations for Lot #57, Pod 14, Lot #45, Pod 23 and Lot#103, carried out on this specified site. The assessment includes excavation dimensions, depth, cleanliness, and the results of soil testing using a hand auger, Dynamic Cone Penetrometer (ASTM STP-399), and general probing tests.
The reinforcing steel was checked for correct size, number of bars, location of bars, spacing, cleanliness, support against displacement, splicing, clearance and steel grade. Reinforcing steel appeared to meet job specifications for size, spacing and quantity.

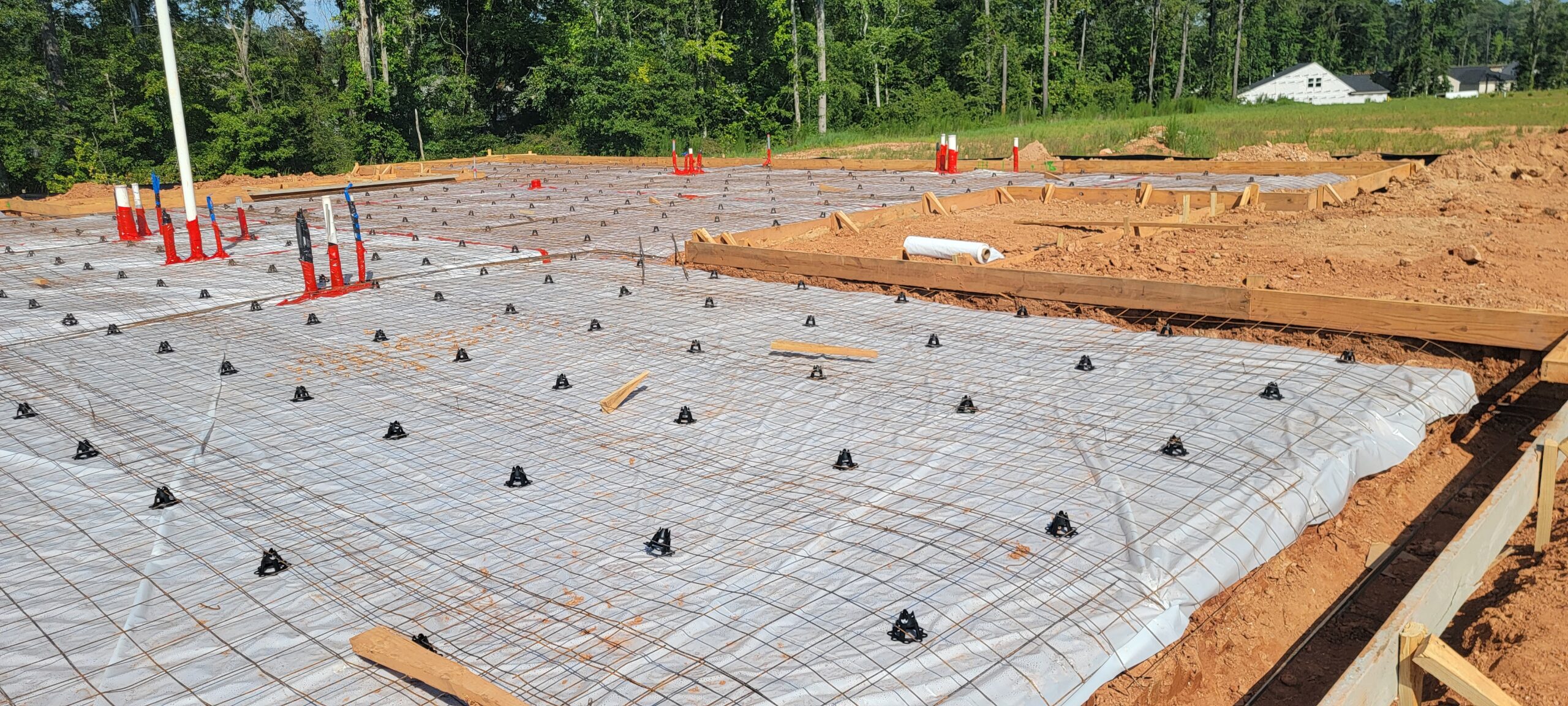

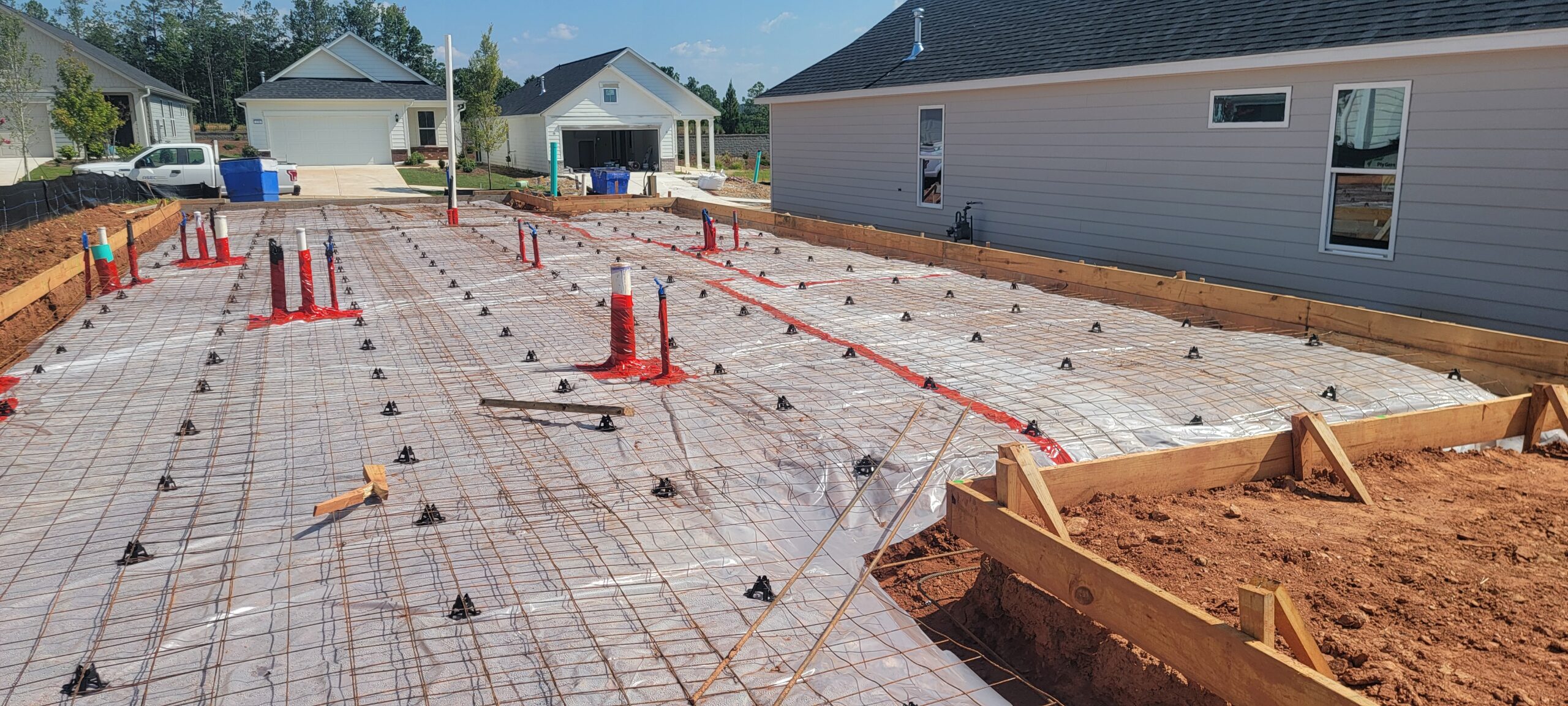

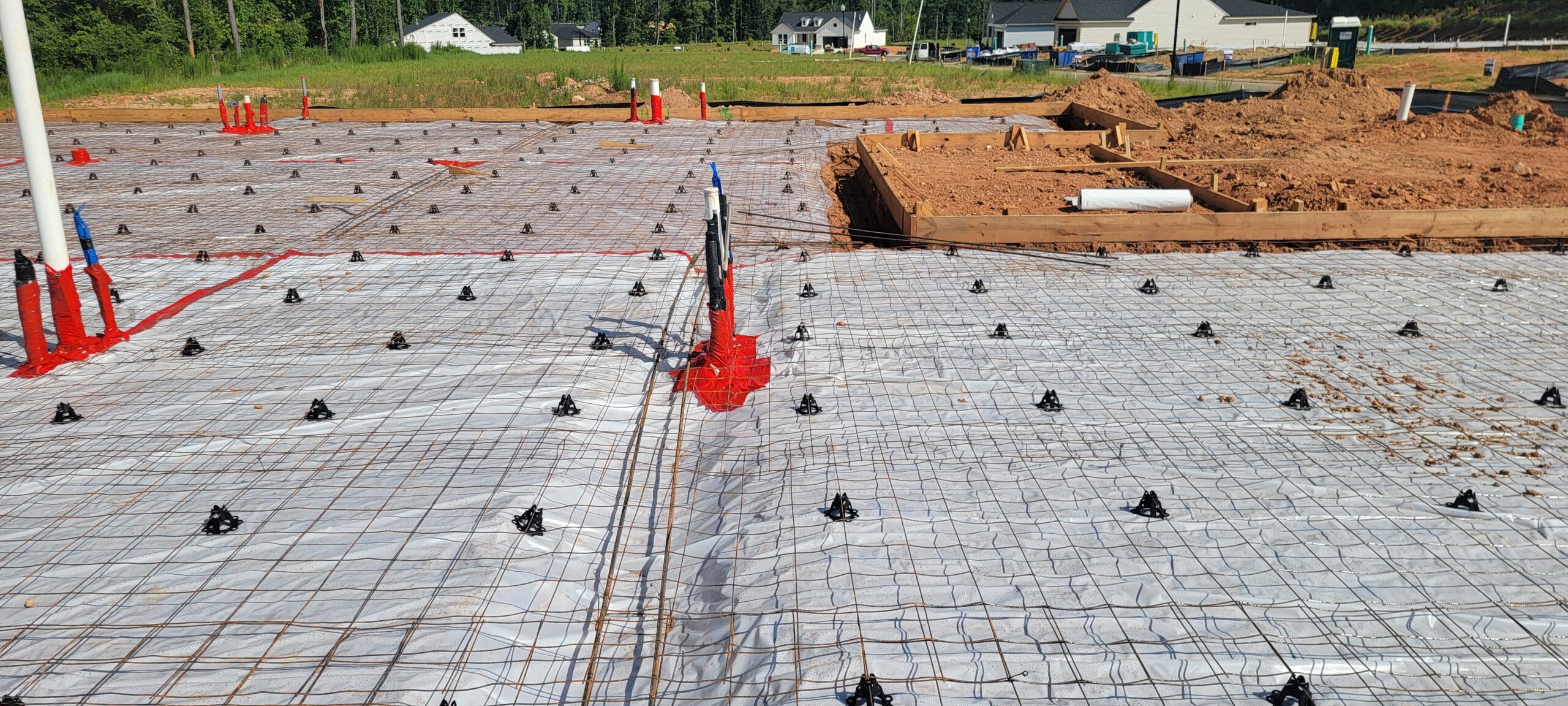

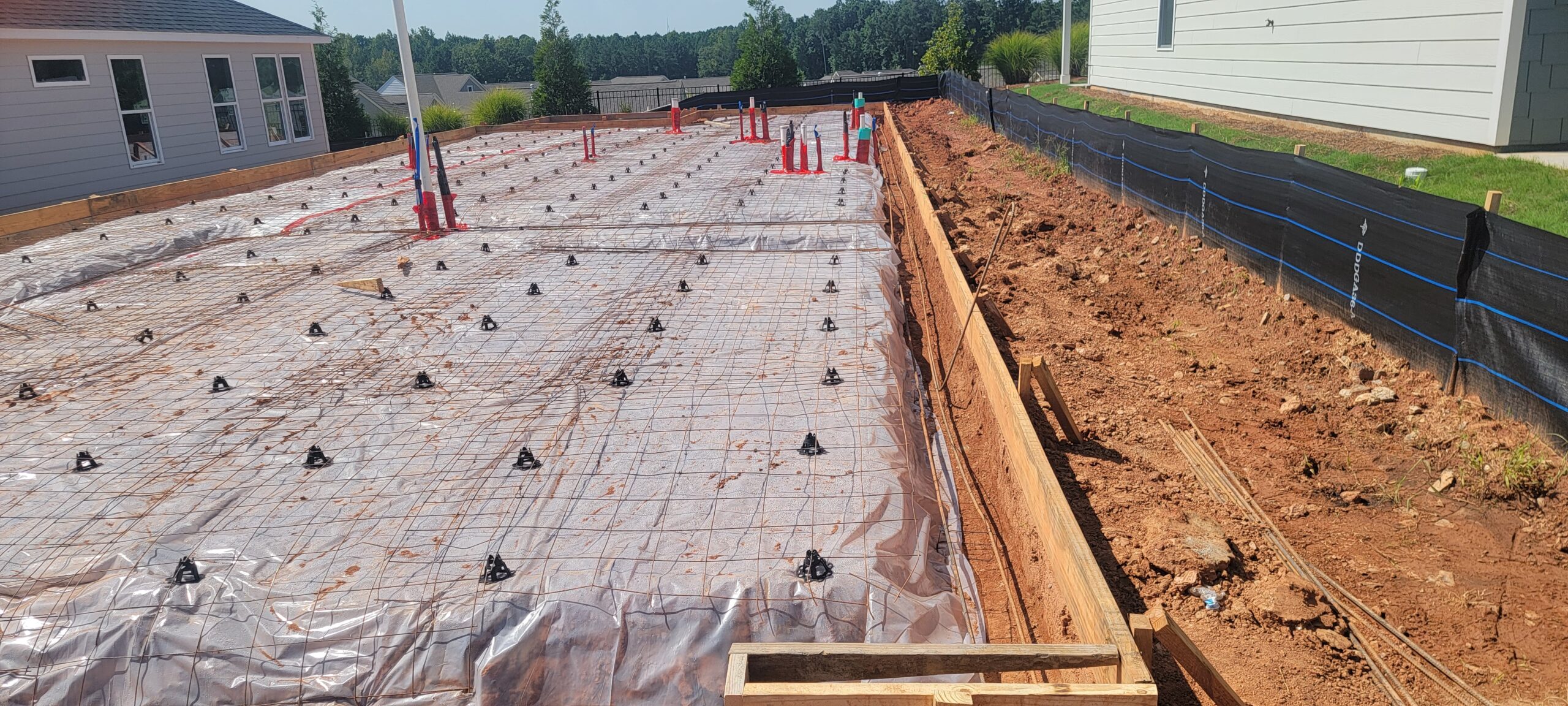

The footing excavations were noted to be in general accordance with the project drawings with respect to size and depth.
Additionally, it was observed that the footing excavations were generally free of loose soil, debris, and water.
Dynamic Cone Penetrometer (ASTM STP-399) results at the test locations displayed soils capable of supporting a net allowable bearing pressure of 2000 psf.

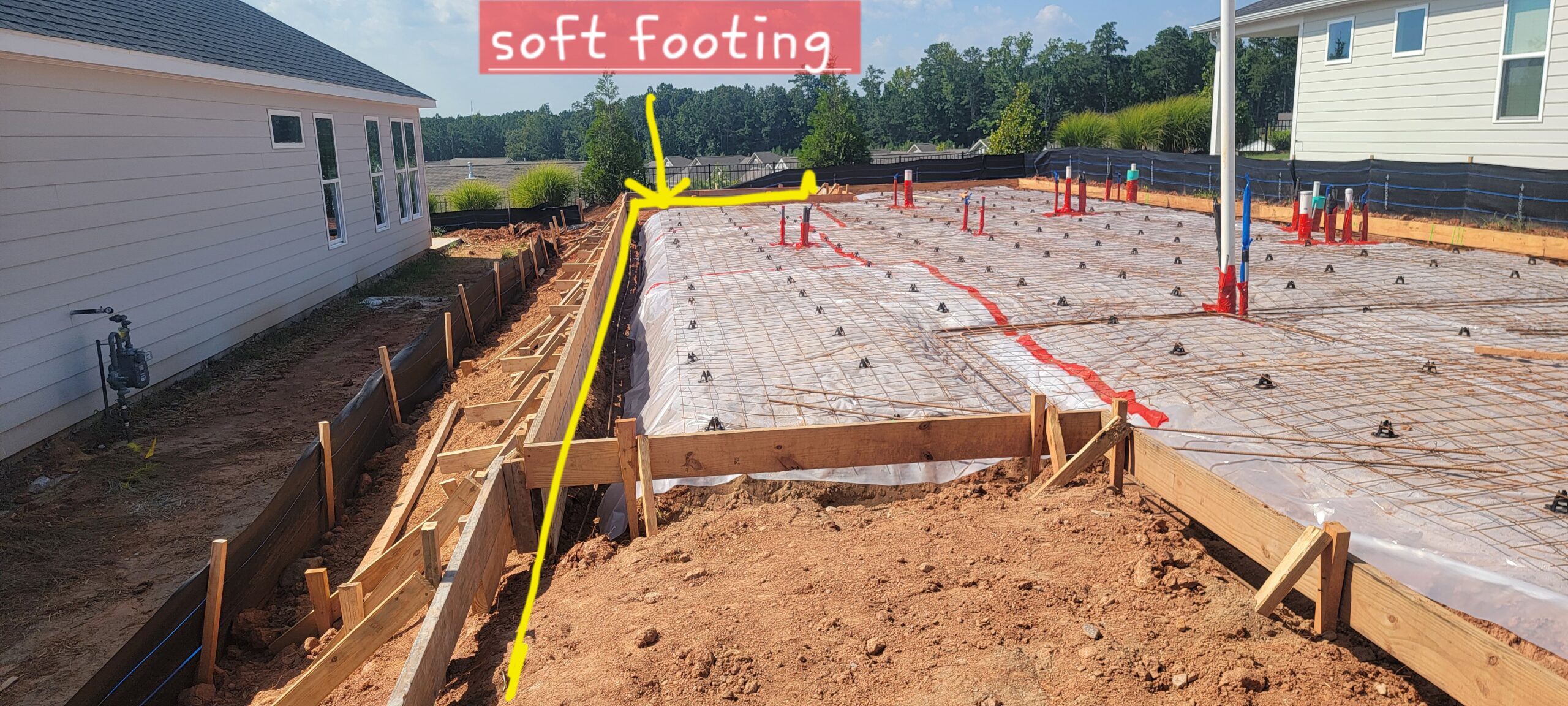

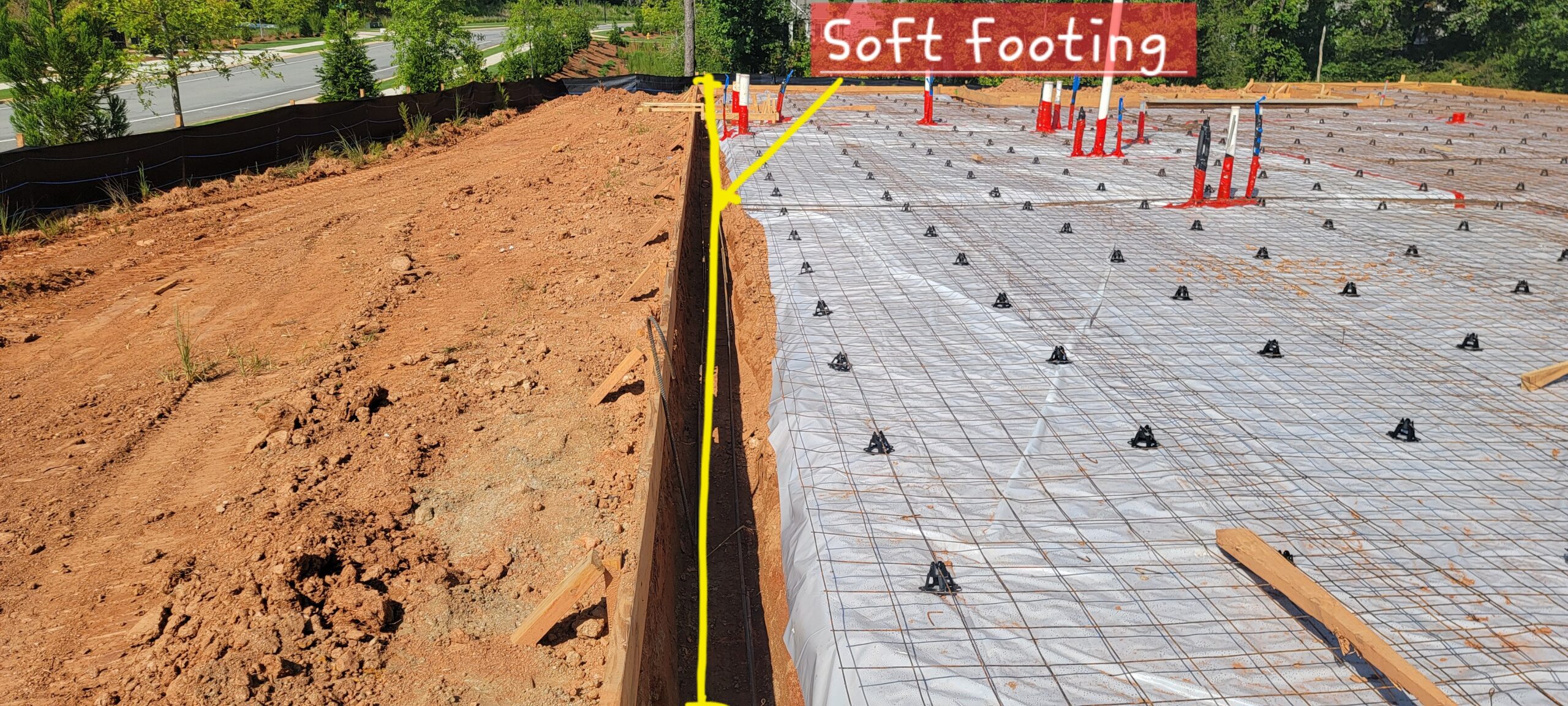

Note: one wall footing for Lot#57, Pod 14, and one wall footing for Lot# 45, Pod 23, soils were not capable of supporting a net allowable bearing pressure of 2000 psf. The locations are shown in yellow color in attached picture. The contractor was informed.
General probing using a 3/8″ diameter probe rod found surficial soils in the base of the footing to be suitable for concrete placement.

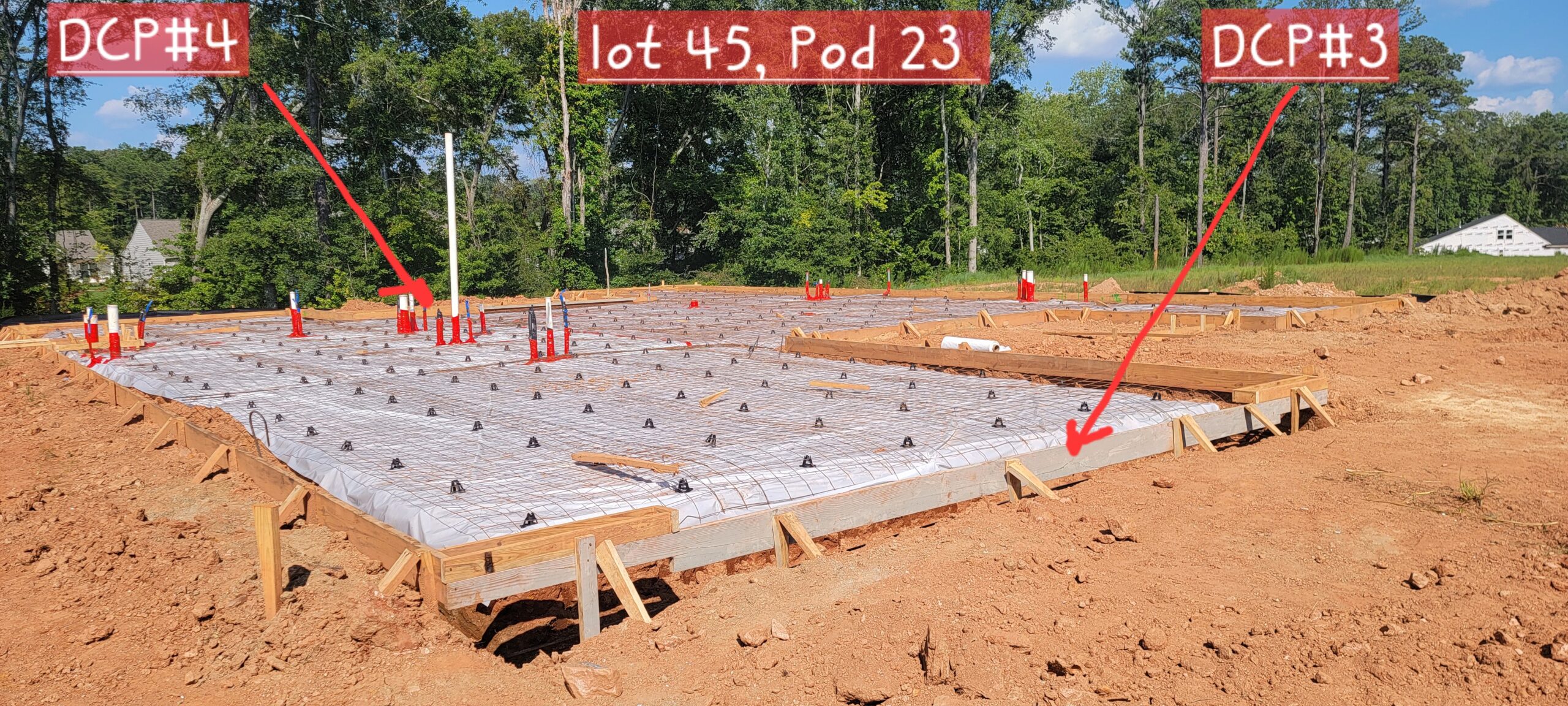

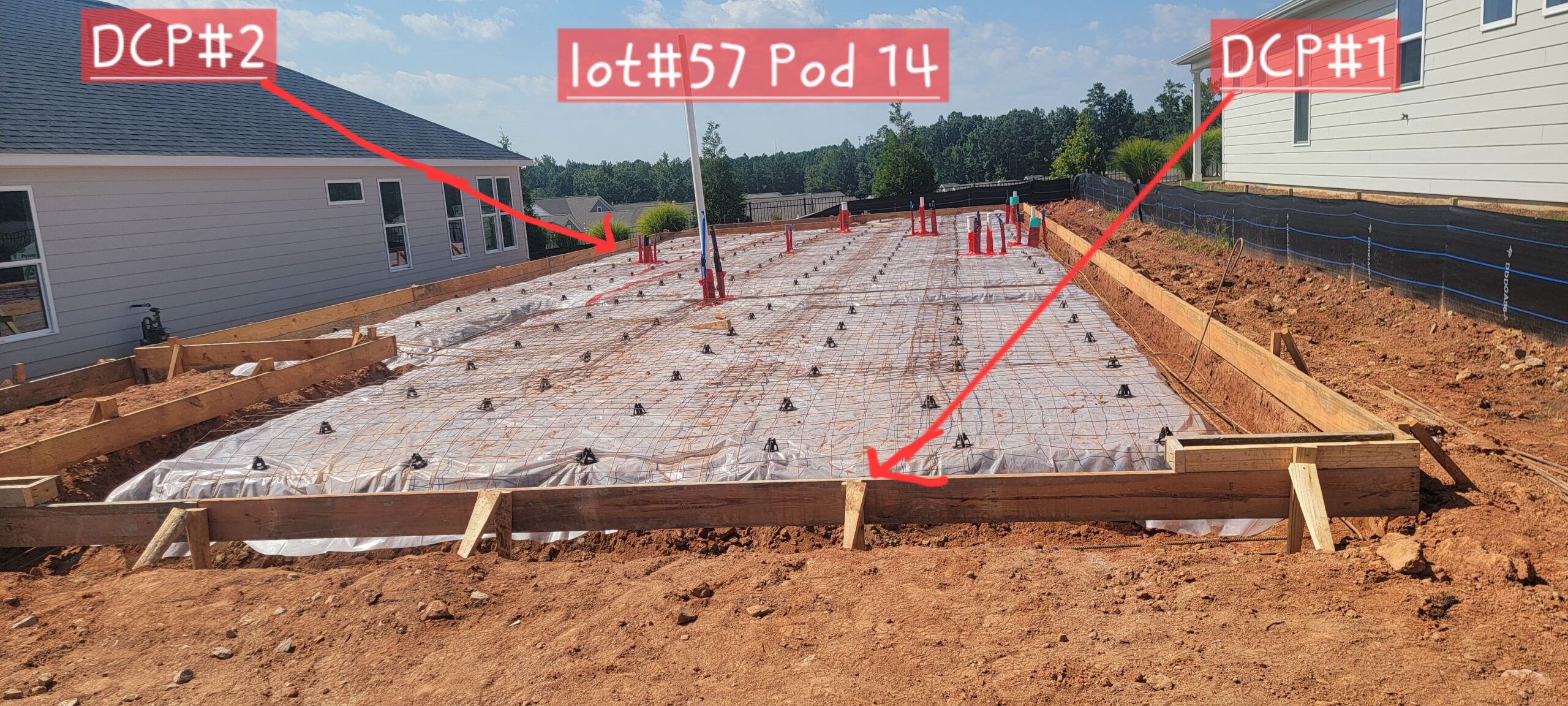

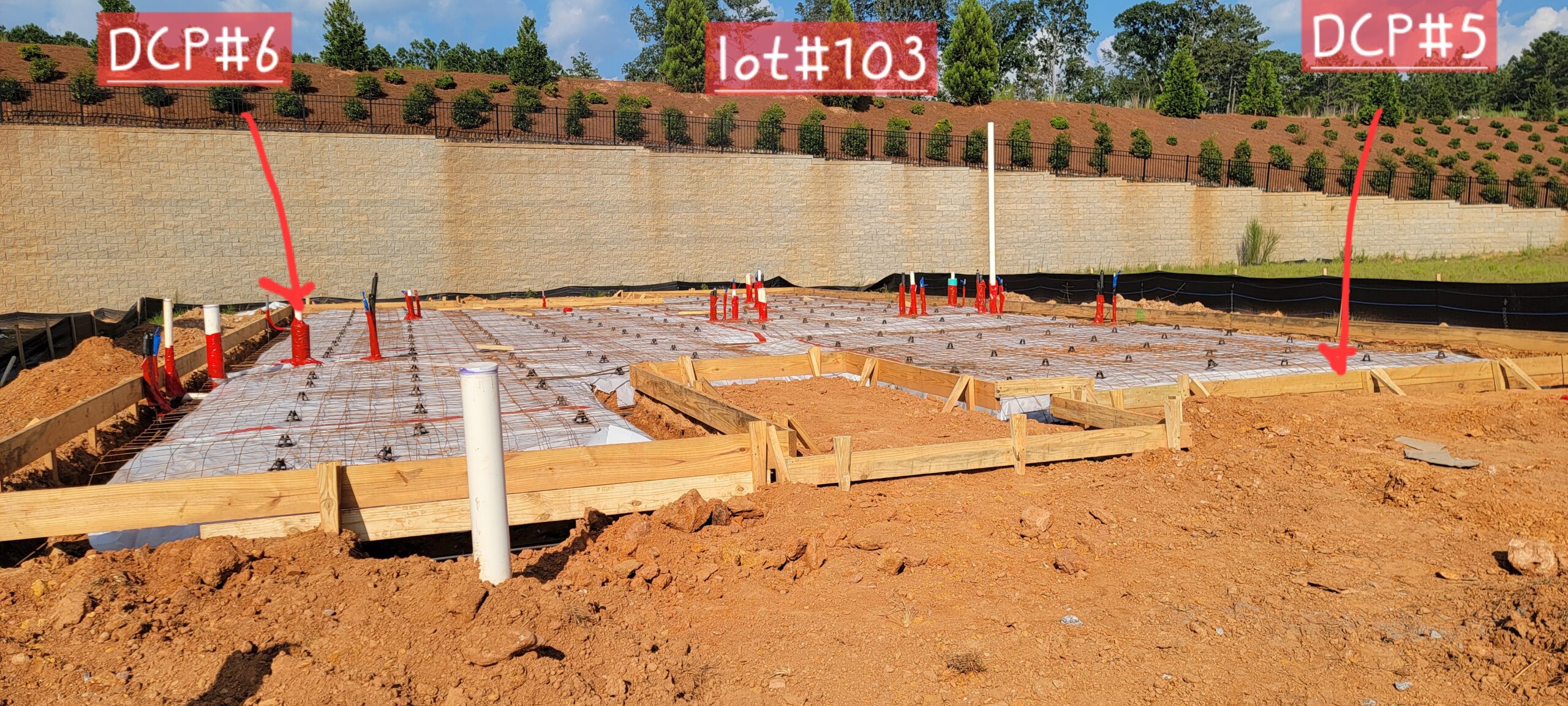

DCP1 Lot 57, pod 14 DCP2 DCP3 Lot 45,pod 23 DCP4 DCP3 lot 103 DCP4
Depth (Feet) | Blows per 3/4″ Increment | Depth (Feet) | Blows per 3/4″ Increment | Depth (Feet) | Blows per 3/4″ Increment | Depth (Feet) | Blows per 3/4″ Increment | Depth (Feet) | Blows per3/4″ Increment | Depth (Feet) | Blows pe3/4″ Increment |
1 | 7 | 1 | 4 | 1 | 4 | 1 | 7 | 1 | 8 | 1 | 7 |
2 | 7 | 2 | 5 | 2 | 4 | 2 | 7 | 2 | 8 | 2 | 7 |
3 | 8 | 3 | 6 | 3 | 7 | 3 | 8 | 3 | 10 | 3 | 8 |
4 | 8 | 4 | 8 | 4 | 7 | 4 | 8 | 4 | 10 | 4 | 10 |
- Footing subgrade conditions should remain dry and free of loose soils/debris prior to concrete placement. If exposed to inclement weather, the foundation subgrade should be re-observed by ASEC,
