Daily Field Report

Date :04/12/2024
Project No :2022C106
Client Company :CWM
Arrival Time :04/12/2024 8:00
Onsite Hours :08:00
Name of the Project :Taxiway 2022 Pavement Replacement
Project Location :HJAIA
Weather :sunny
Departure Time :04/12/2024 16:00
ASEC Technician Name :Aminullah Azimi

Observations/Finding

At the request of the client’s representative, our AS ENGINEERING AND CONSULTING, LLC (ASEC) representative visited the job site to observe the contractor’s work activities from a quality standpoint to verify compliance with project drawings/specifications, applicable codes, and materials submittals and conducted QC testing per the project drawings and specifications.  The following observations were made on site this shift:

  • CWM continues to mill the NLVR location on the west face of the taxiway contractor using milling machine to mill the asphalt and stockpile on site.

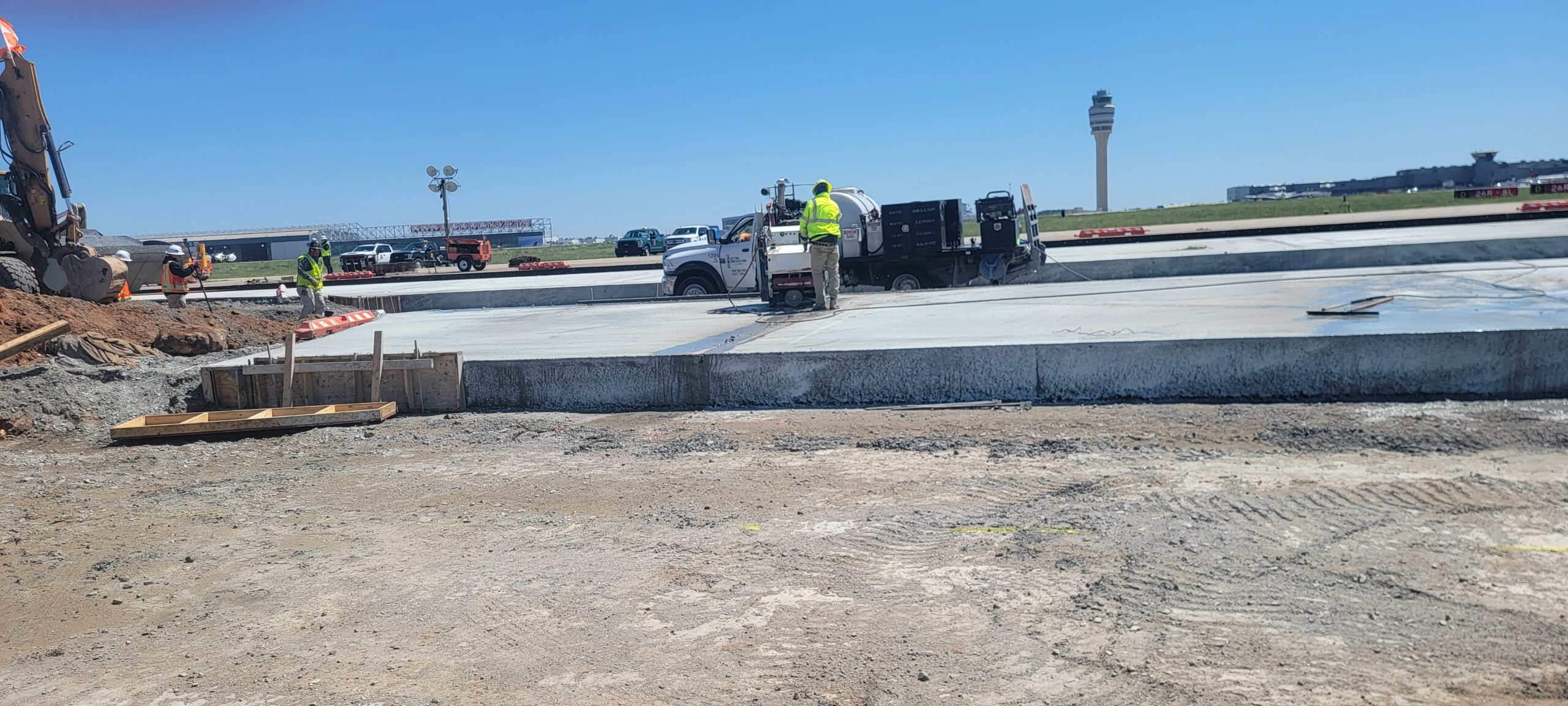

  • CWM strip forms after the concrete setup in phase 7A, lane 1 and 3, and preparation the form work for lane 4.

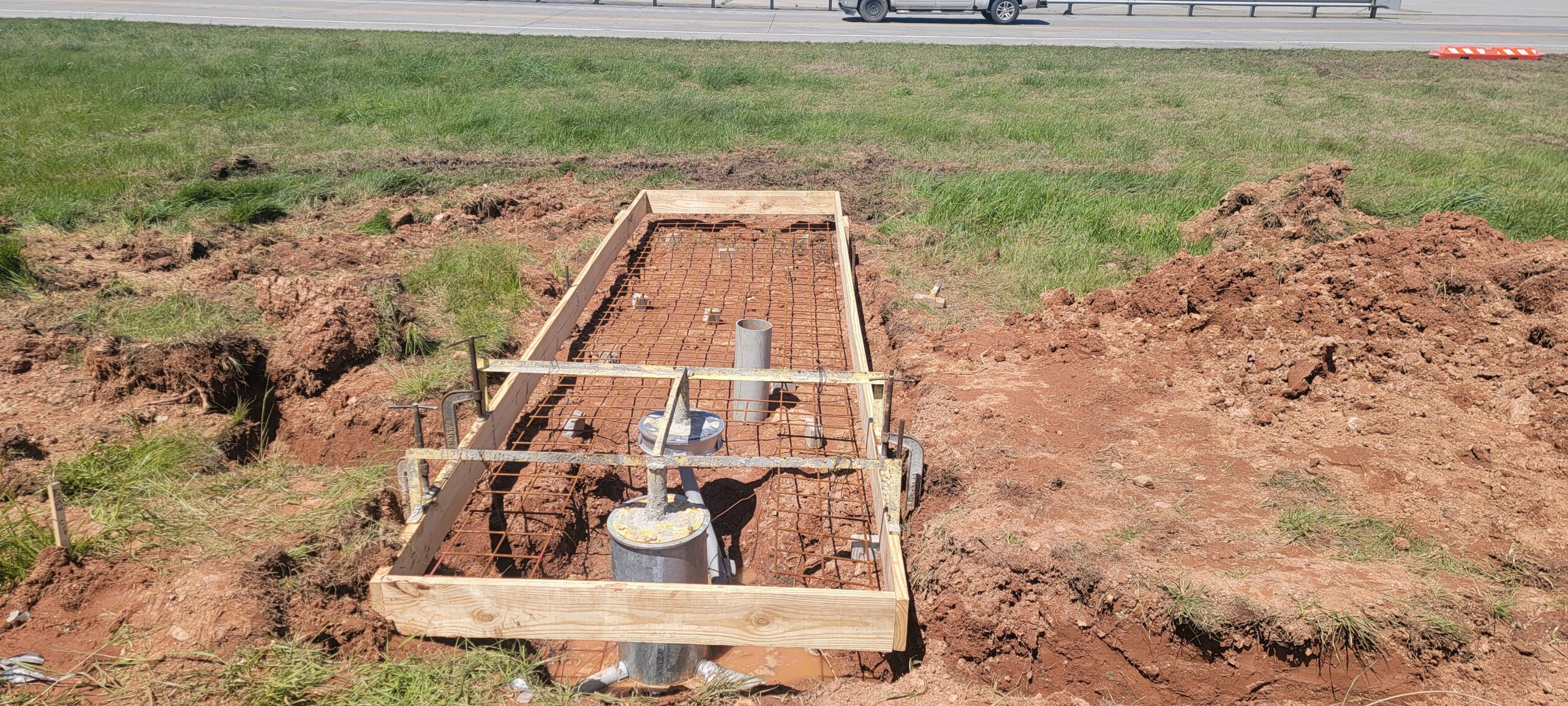

  • BBH formed up for the sign base of A37 to place concrete.

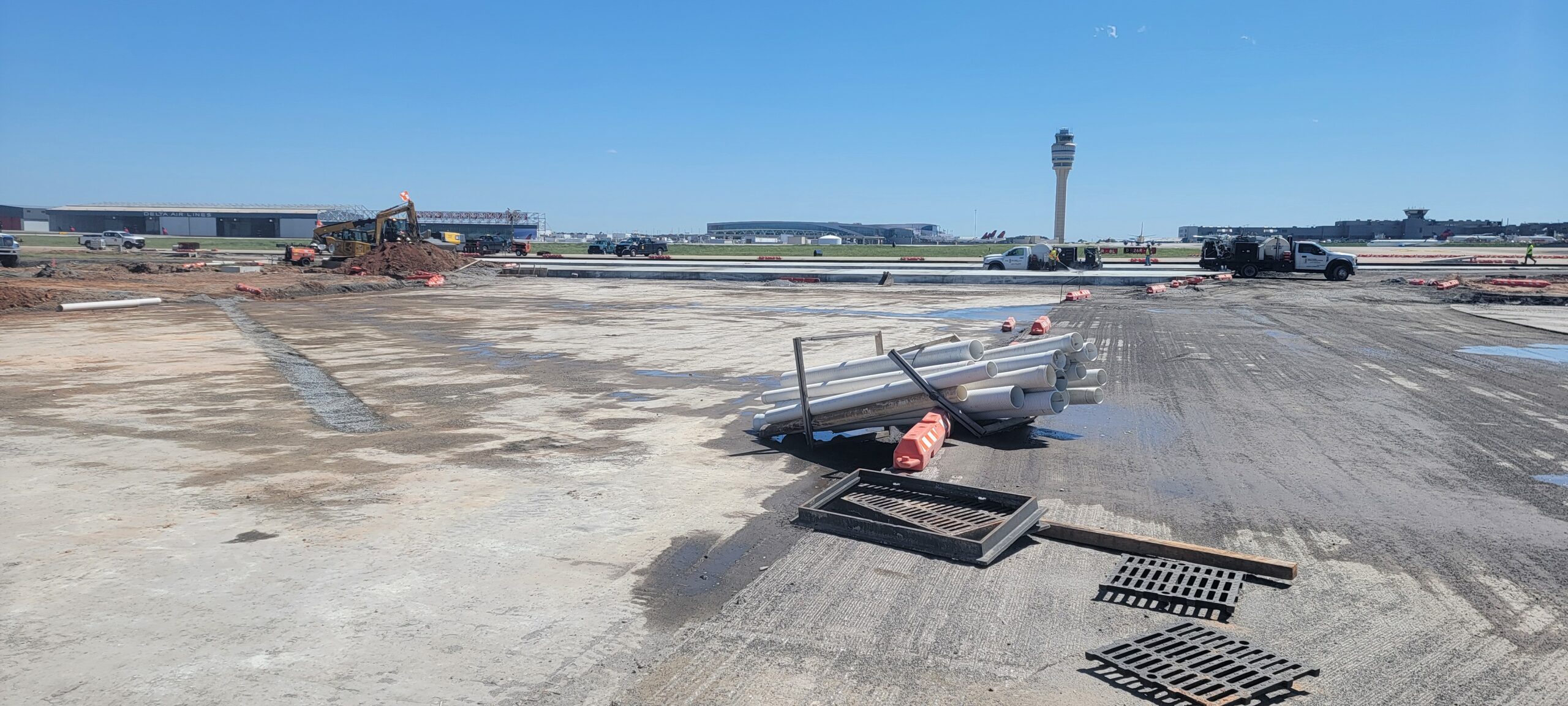

  • ABC sawed the joints for lane 1 and 3.

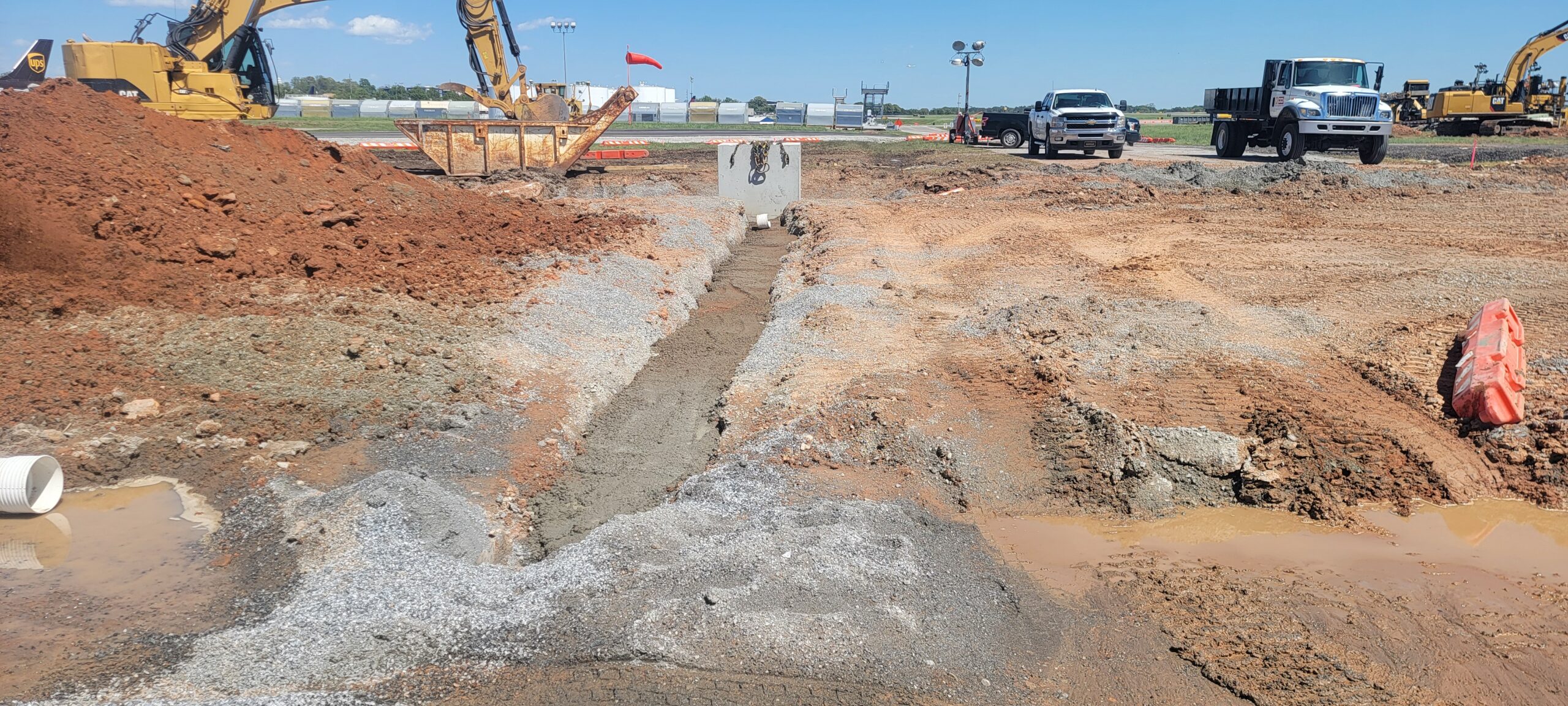

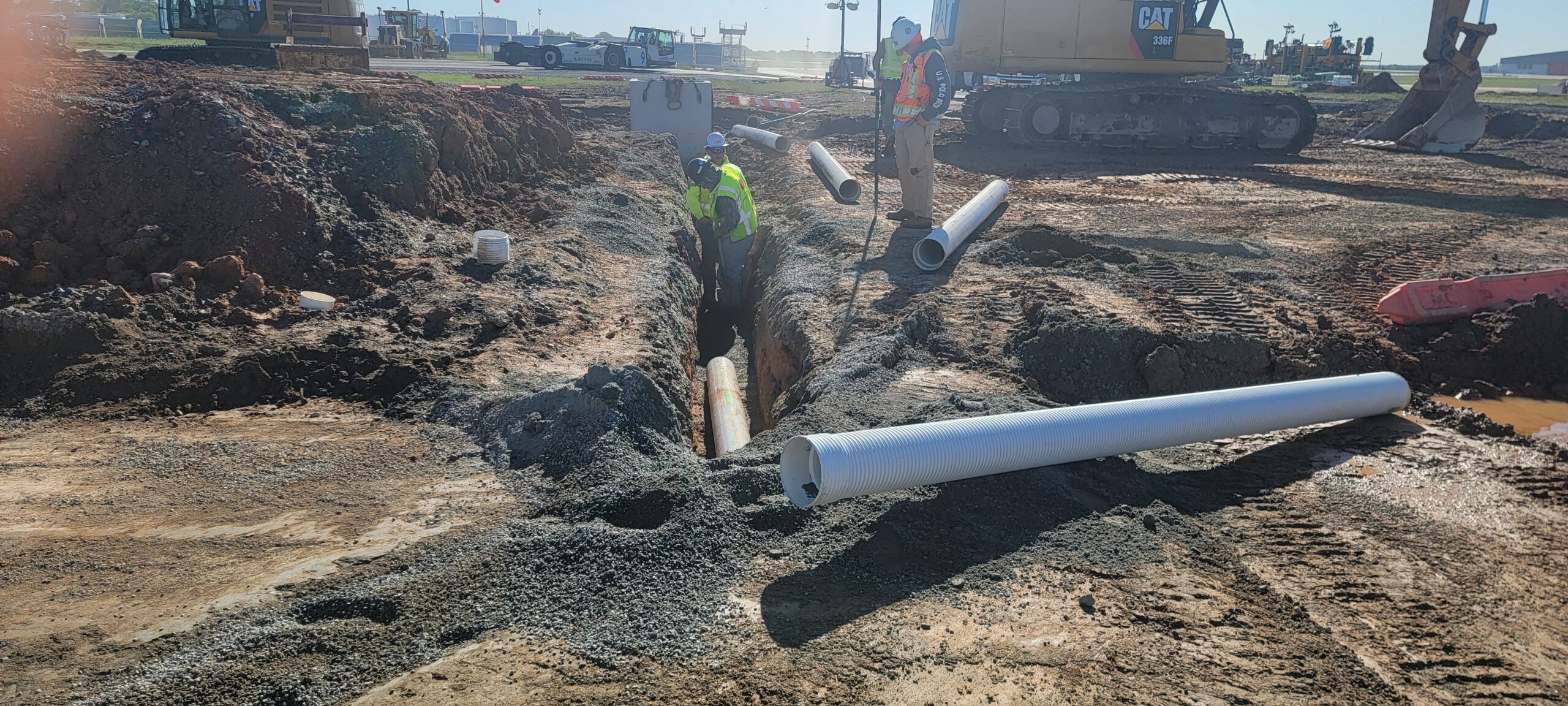

  • Kelly poured the concrete incase the under drains from the edge of the purposed taxiway running east toward manhole A-3.

In case of any questions or concerns with regards to our observations or recommendations stated in this report we will be more than glad to discuss them with you.

Technician Signature / DateAminullah Azimi, April 12, 2024
Reviewer Name / DateKenneth Mosman, May 23, 2024
