- Daily Field Report Report ID: 63441
- This project is inactive from admin.Download Report
Daily Field Report
Date :12/19/2023
Project No :2023C141
Client Company :Toll Bros
Arrival Time :12/19/2023 12:00
Onsite Hours :04:00
Name of the Project :N. Gate - Old Atlanta Road
Project Location :Cumming
Weather :sunny
Departure Time :12/19/2023 16:00
ASEC Technician Name :Aminullah Azimi
Observations/Finding
As requested, the site was visited by our AS Engineering and Consulting (ASEC) representative for the purpose of providing quality control inspection and testing services. Visual observation techniques were employed to verify compliance with project drawing/specifications, applicable codes, and materials submittals. The following observations were observed on site this day.

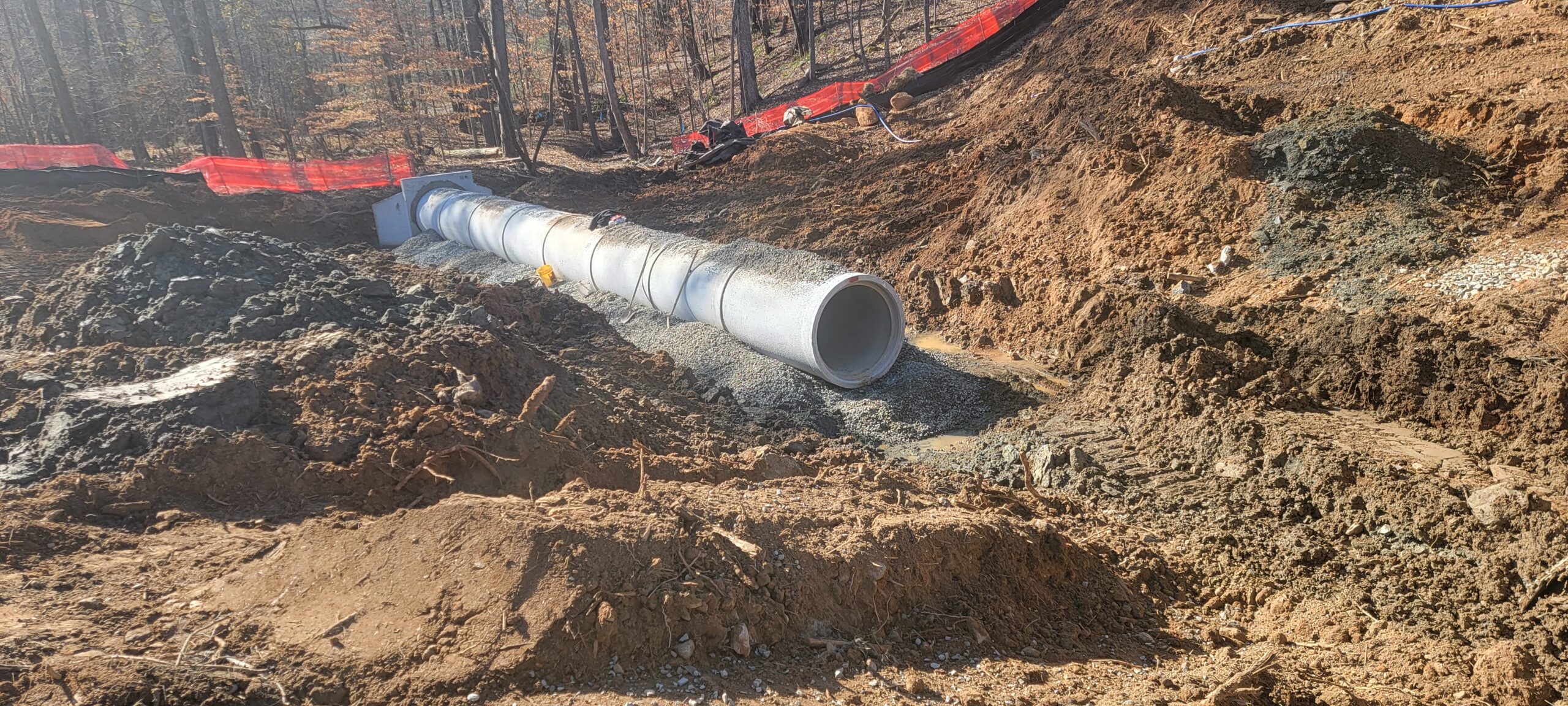

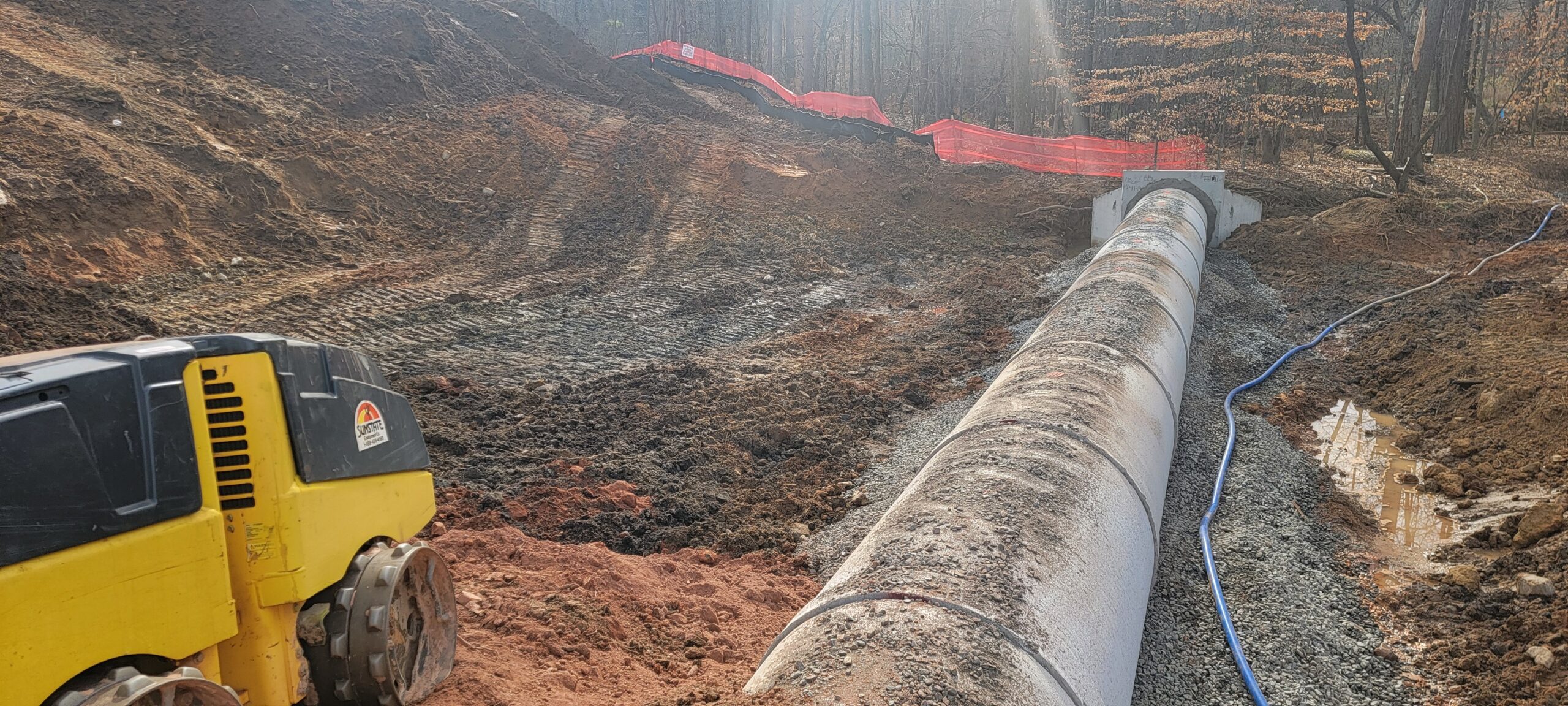

- The placement and compaction of fill soils for Lot #32 and roadway in the front of Lot #32, continued this day.

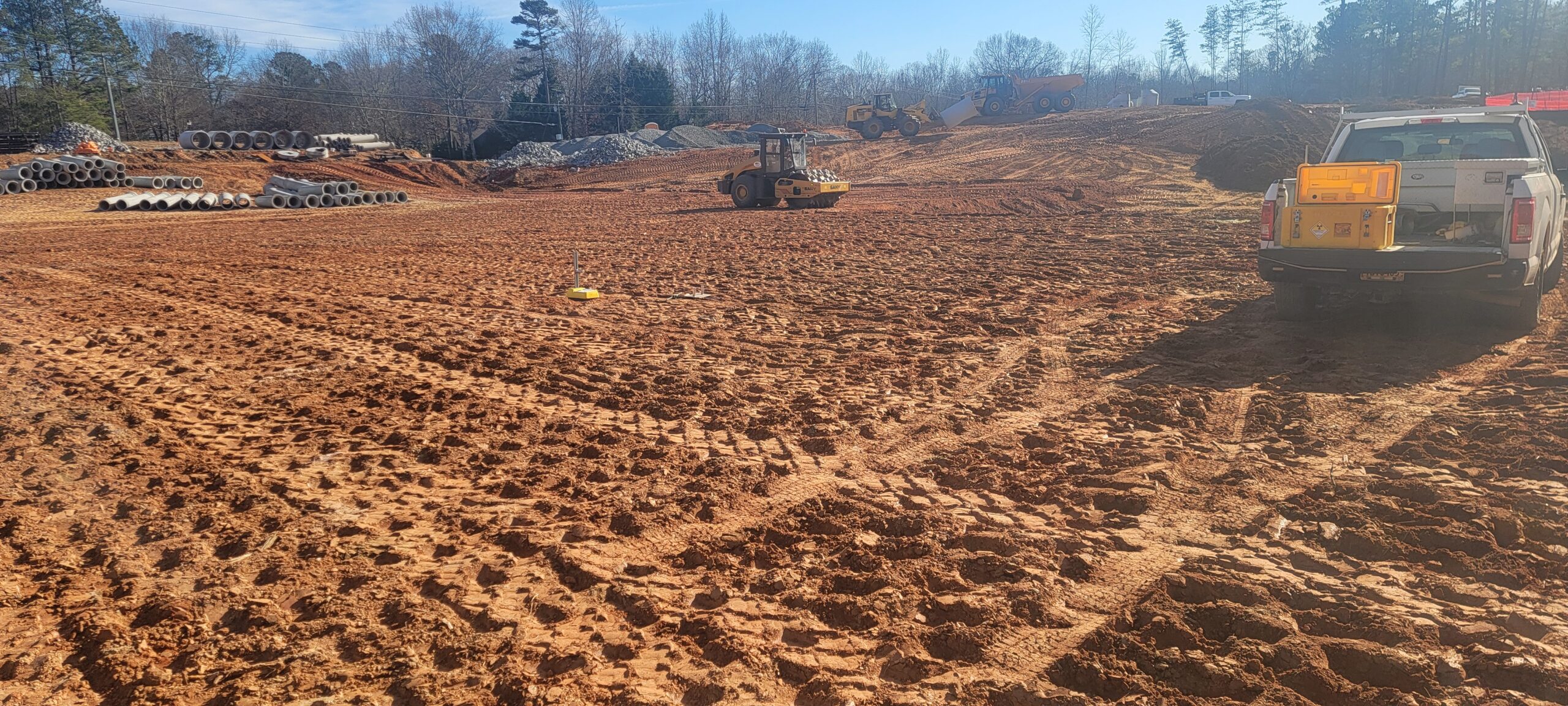

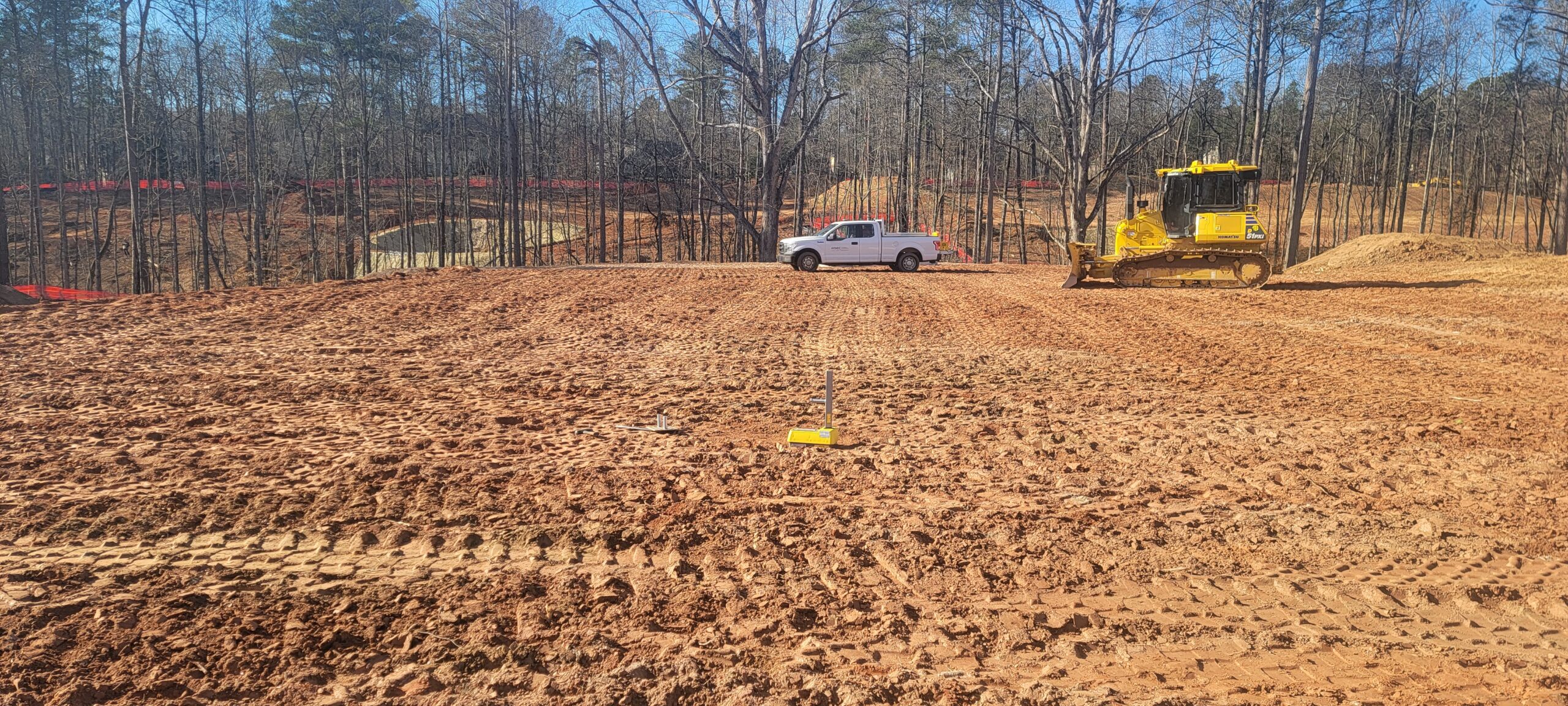

- At the time of arrival, our representative observed that work was in progress with one (1) foot lifts being placed, compacted using a sheeps-foot compactor.
- Density test results indicate that the compacted materials met the project requirement of 90% of the maximum dry density obtained by the (Standard Proctor ASTM 698).

- A footing evaluation was performed by visual inspection and probing testing for the culvert footing,
- During the evaluation, some soft and muddy soils (some with organics) were encountered. We recommended the removal of approximately 4 feet of these unsuitable soils to reach suitable residual soils.
We appreciate the opportunity to be of service to you on this project. If you have any questions regarding this report, please feel free to contact us. We will be more than happy to discuss it with you.
Technician Signature / DateAminullah Azimi, December 19, 2023
Reviewer Name / DateKenneth Mosman, March 09, 2024
