Daily Field Report

Date :06/28/2023
Project No :2022C235
Client Company :Jackson Demolition Service, Inc.
Arrival Time :06/28/2023 06:00
Onsite Hours :10:30
Name of the Project :Plant Gorgas Demolition and Grading
Project Location :460 Gorgas Rd, Parrish, AL 35580
Weather :SUNNY
Departure Time :06/28/2023 16:30
ASEC Technician Name :Avinash Bandham

Observations/Finding

AS ENGINEERING AND CONSULTING, LLC (ASEC) representative Avinash Bandam visited the site at the request of Jackson Demolition representative Josh Kelly. The undersigned representative was present to monitor, verify and document the ongoing project activities. (Reference drawing E720661 S1 – R8, E720659 S1-R8.)

During the visit, the following observations were made:

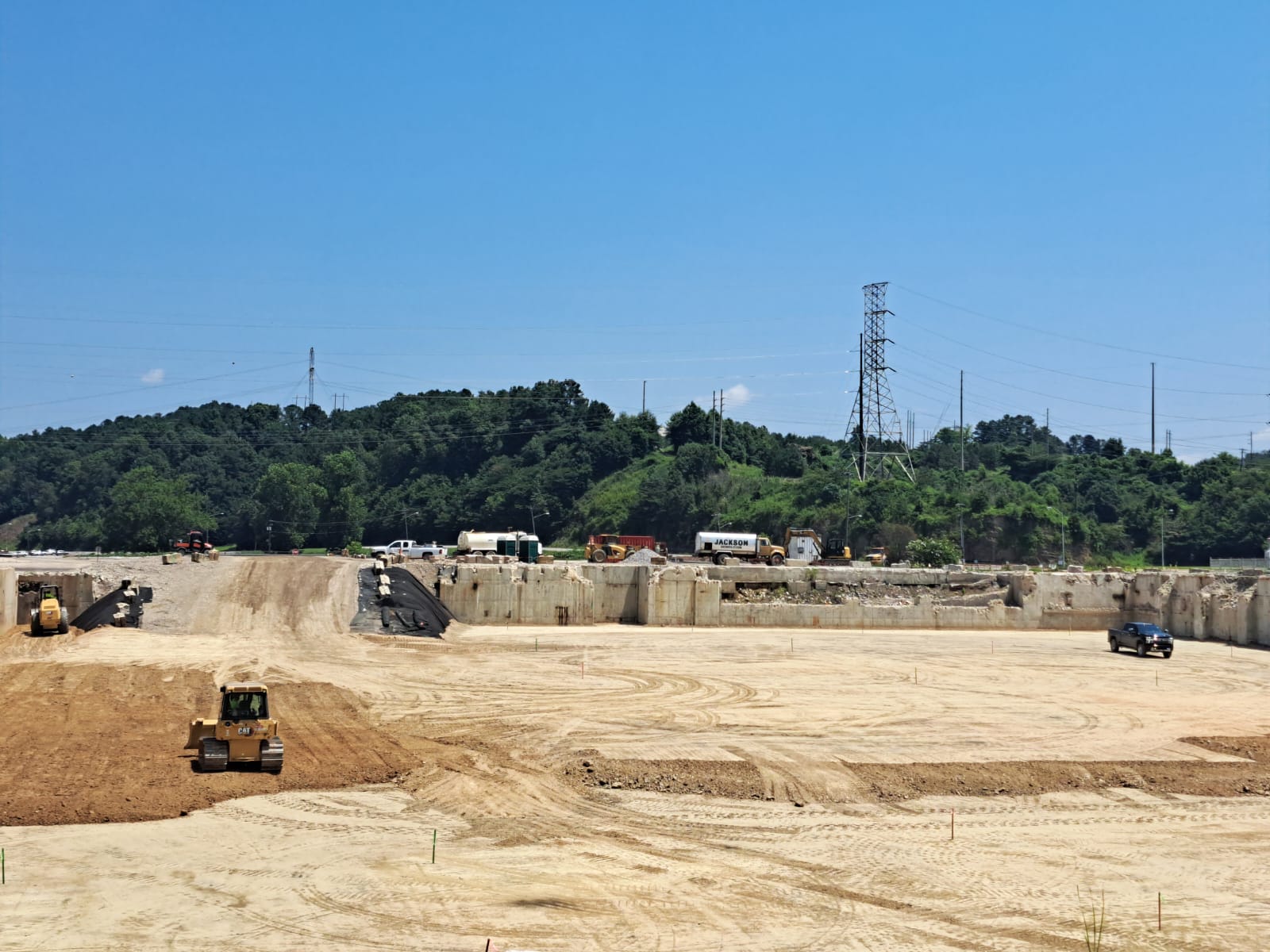

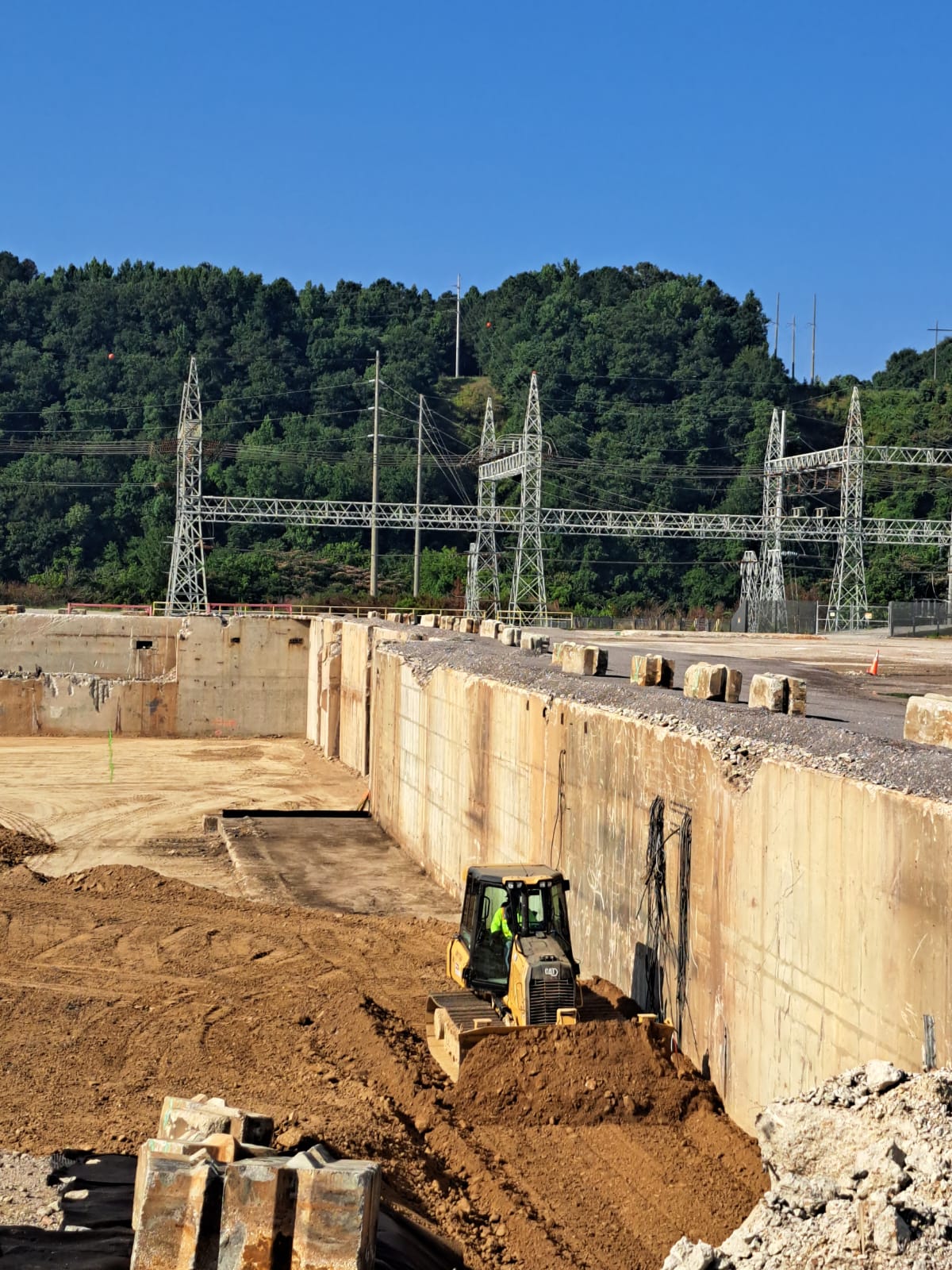

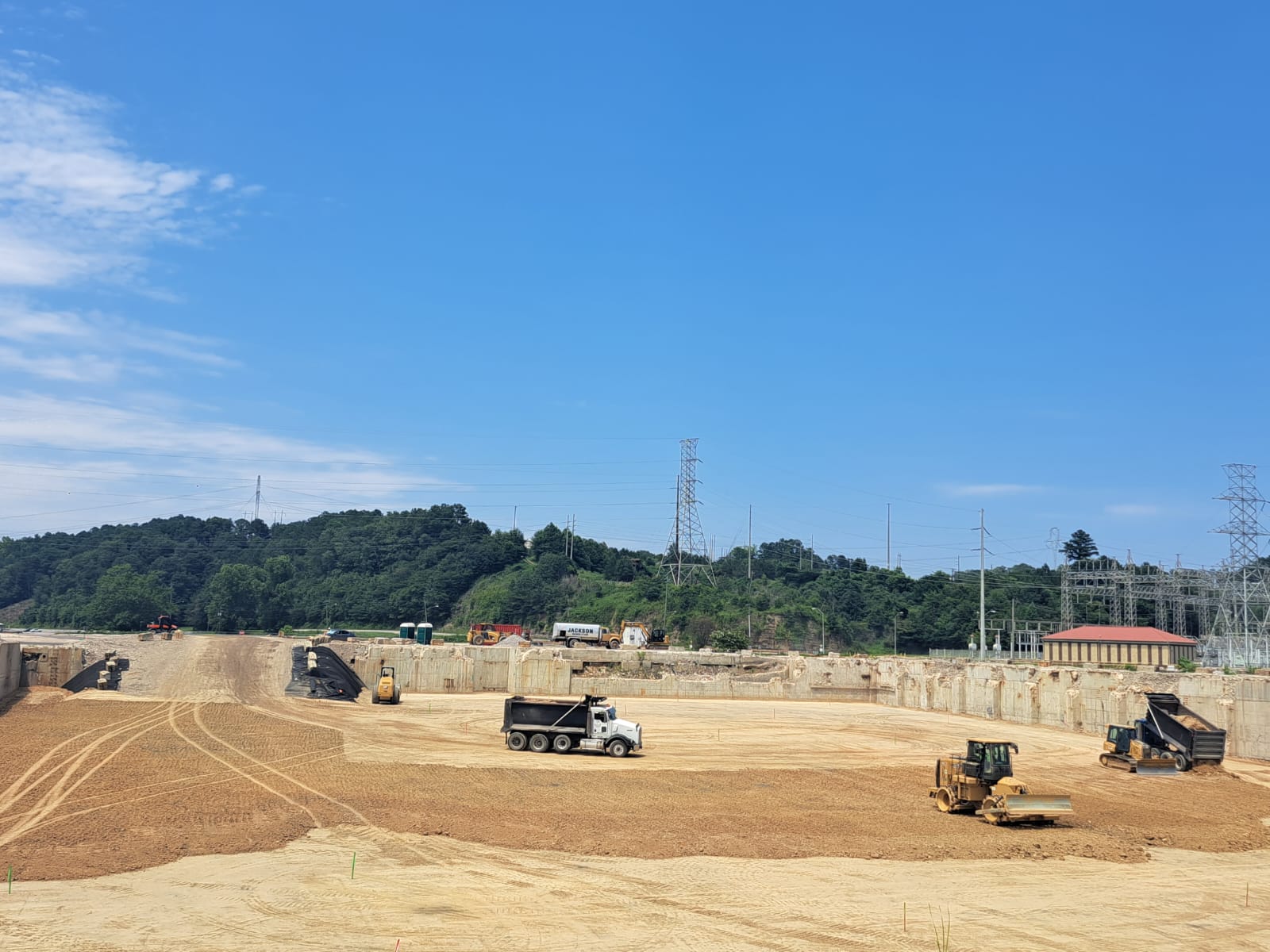

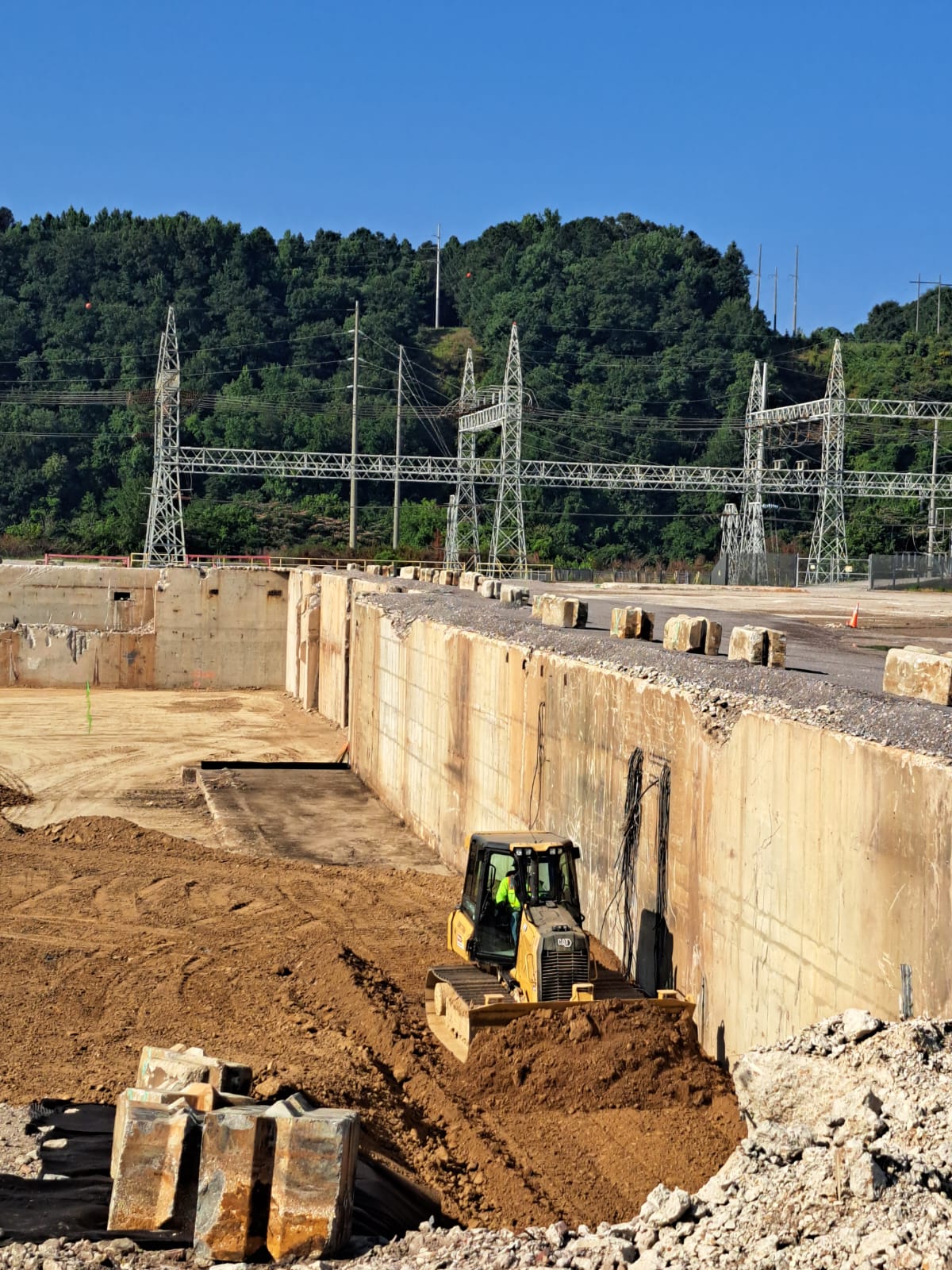

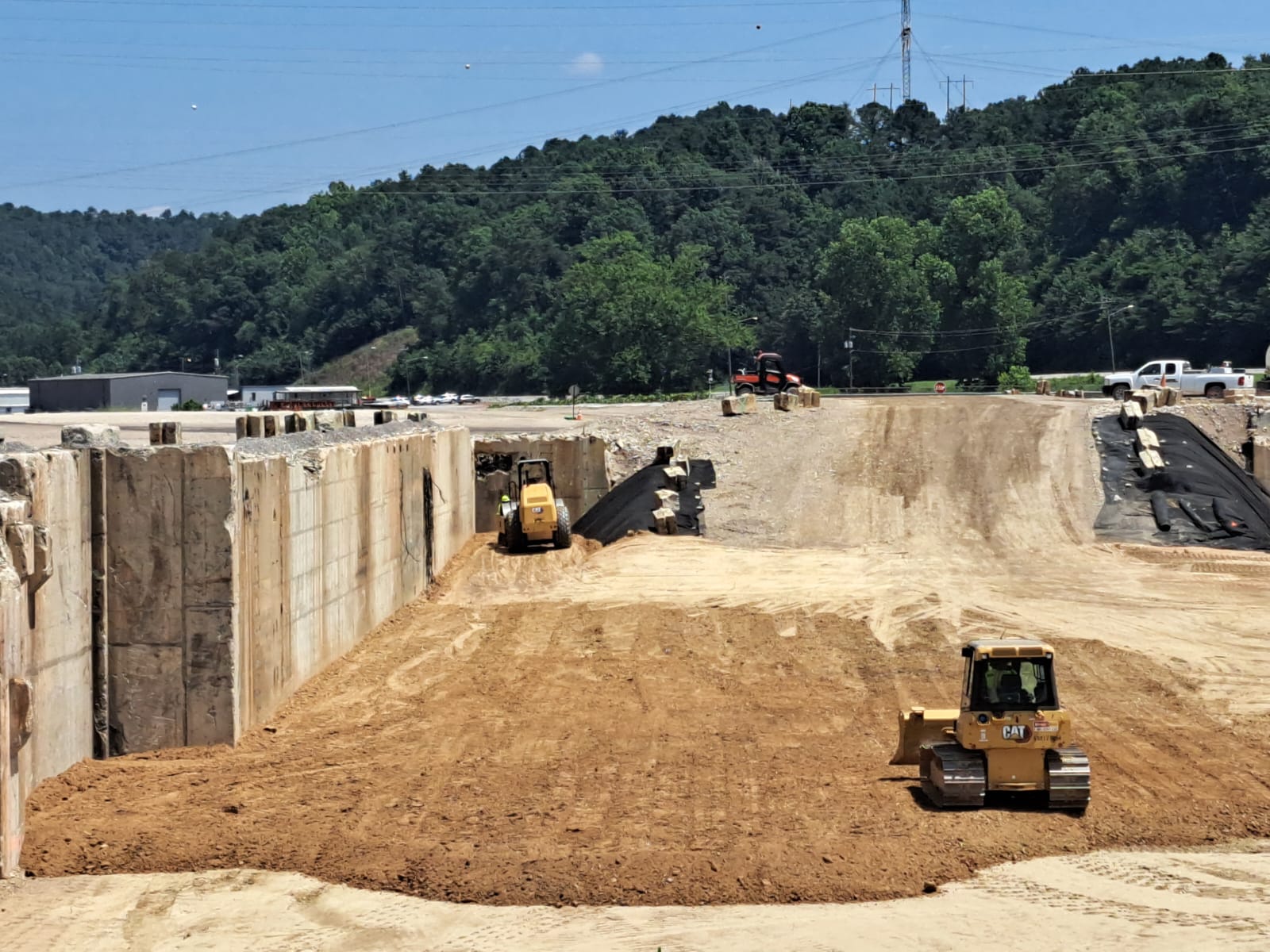

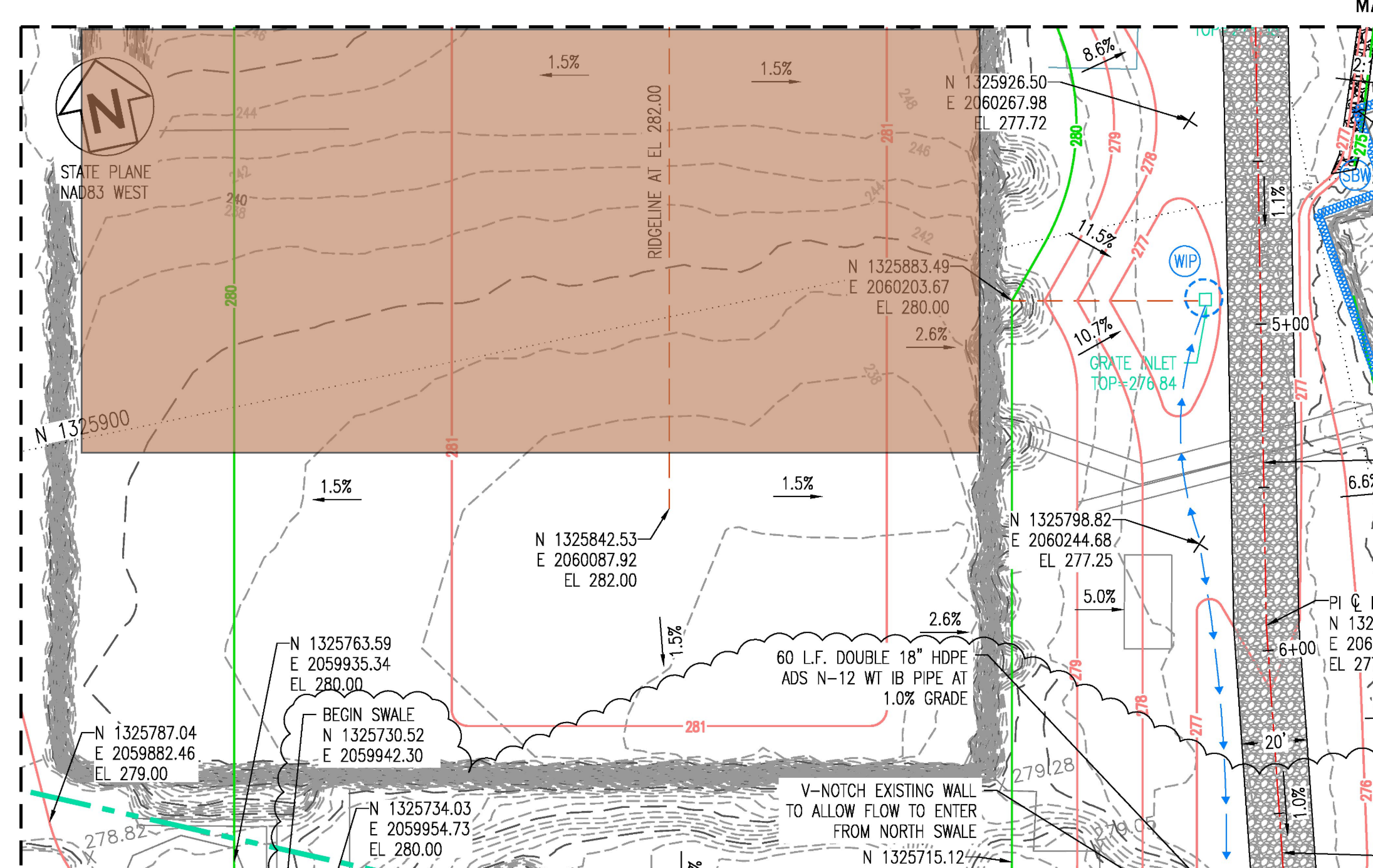

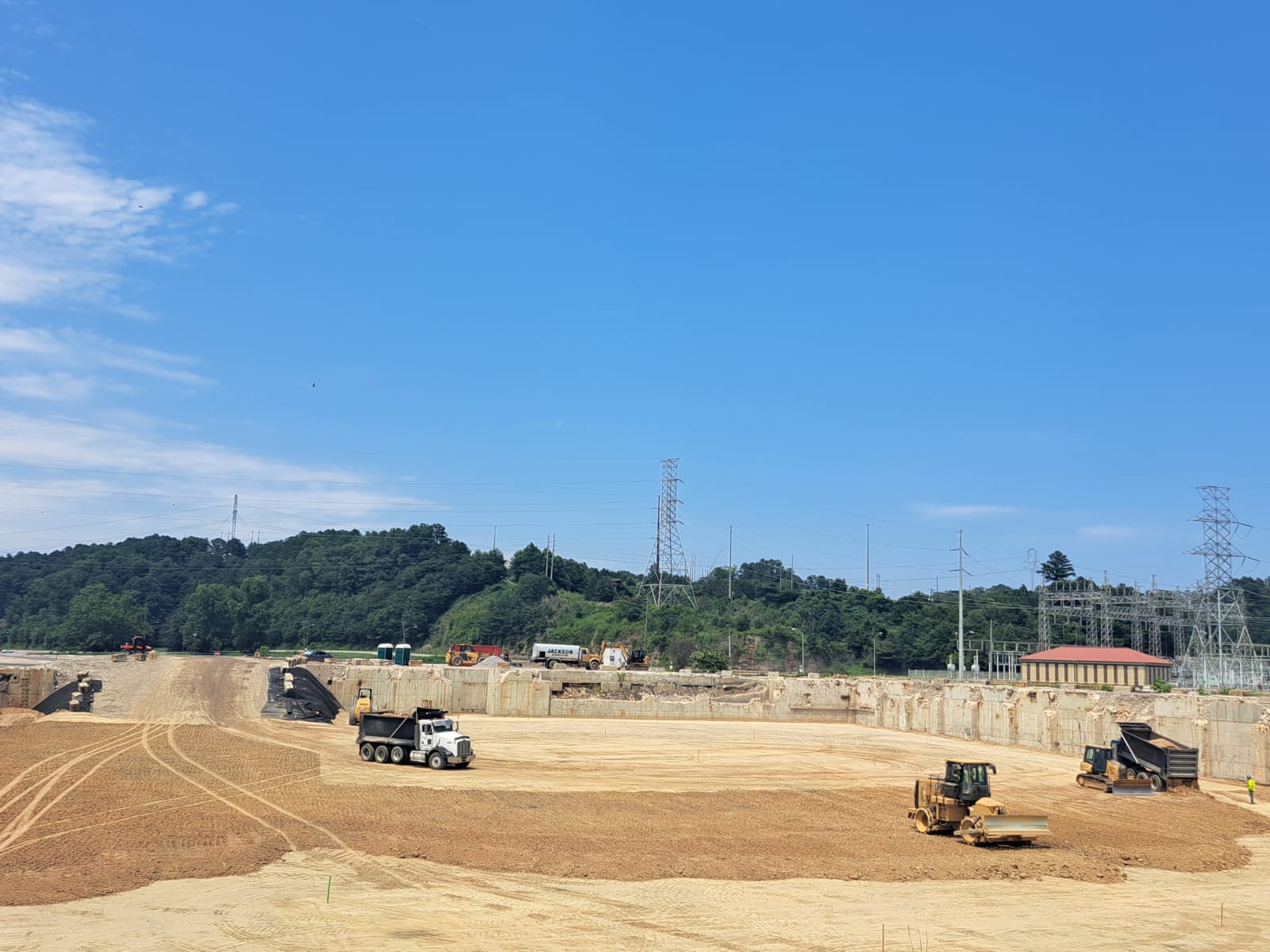

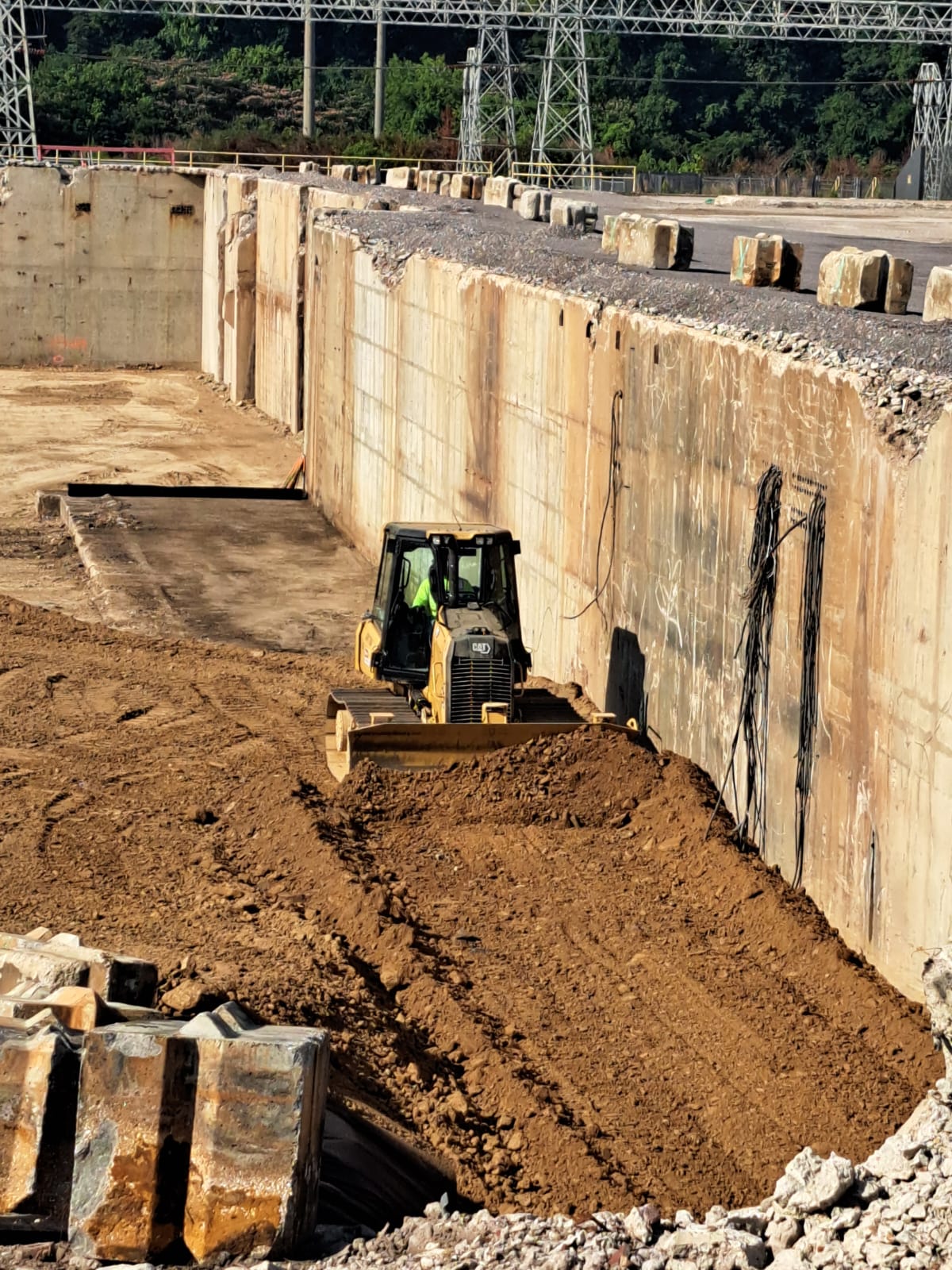

  1. One thousand five hundred and twelve (1512) cubic yards of fill materials were placed for lift (17) in section 1 area B7 (E720661 S1-R8) and started and continued the placement of section 2 part 1 area G7 (E720659 S1-R8) for the lift (16). The materials were placed and compacted in accordance with ITP-001, and the fill area is highlighted in brown as depicted in the attached drawing.

  2. The fill material was covered in gaps at the west end wall beside the ramp. The materials were placed and compacted in accordance with ITP-001.

We appreciate the opportunity to be of service to you on this project. If you have any questions regarding this report, please feel free to contact us. We will be more than happy to discuss it with you.

Technician Signature / DateAvinash Bandham, June 28, 2023
Reviewer Name / DateRamchandra Mogulla, July 06, 2023
